Define the Activity, Site, and Project Responsibilities

Do not start by choosing a depth or ordering foam cubes. Start by writing a project brief. A useful brief defines six inputs: activity, users, entry method, site, jurisdiction, and operations. These inputs give the equipment supplier and local professionals enough context to discuss a system instead of guessing from a floor area.
| Project input | Questions to answer | Why it matters |
|---|---|---|
| Activity | Is the pit for trampoline dismounts, gymnastics training, children's play, or another planned use? | The activity changes the entry path, landing conditions, supervision, and system configuration. |
| Users | What ages, sizes, skill levels, and user groups will the venue admit? | User assumptions affect operating rules, access, assistance, and capacity planning. |
| Entry | Will users enter from a trampoline, platform, runway, or another device? | The approach and landing direction must be coordinated with the pit rather than designed separately. |
| Site | What are the clear dimensions, available height, floor conditions, and adjacent circulation routes? | The structure must fit the building while leaving workable entry, exit, inspection, and service access. |
| Jurisdiction | Which country, city, insurer, and approval bodies apply? | Equipment standards do not replace local building, fire, planning, or accessibility requirements. |
| Operations | Who will supervise, inspect, clean, document, close, and reopen the attraction? | The design must support the tasks the operating team will actually perform. |
For trampoline parks, ISO 23659:2022 addresses design, construction, inspection, maintenance, and minimum operational requirements, and its public scope expressly includes landing areas such as foam pits. The same scope also excludes general building, fire, and planning regulations. That boundary matters: selecting equipment under a trampoline-park standard does not settle every approval required for a building project.
In projects where ASTM standards are relevant, ASTM F2970-22 provides criteria and operational considerations for institutional trampoline courts. ASTM identifies architects, designers, engineers, contractors, manufacturers, inspectors, owners, and operators among the parties expected to consider the practice. Whether it is legally required, contractually required, or used as voluntary guidance depends on the project and jurisdiction.
The responsibility matrix below is a discussion tool, not a substitute for a contract. The final allocation must be written into the project documents.
| Decision or deliverable | Venue owner | Equipment supplier | Installer | Local professional or authority |
|---|---|---|---|---|
| Intended activity and users | Defines the business and operating need | Tests whether the requested system fits its product scope | Reviews installation implications | Reviews when required by local rules or professional scope |
| Site information | Supplies surveys, drawings, and known constraints | Identifies required interfaces | Verifies accessible site conditions | Confirms building or engineering matters within its discipline |
| Equipment configuration | Approves the brief | Designs or specifies the supplied system | Installs to approved documents | Reviews applicable regulated work |
| Building, fire, and approvals | Coordinates the project process | Supplies relevant product documents | Supports site coordination | Confirms local requirements and approvals |
| Inspection and handover | Accepts procedures and assigns staff | Provides system instructions and records | Completes installation checks | Participates when the project requires it |
| Ongoing operation | Implements supervision, inspection, cleaning, and records | Provides product-specific limits and service information | Addresses installation defects within scope | Performs required inspections or professional services |
A buyer should leave this stage with a written brief, a preliminary responsibility list, and a record of unresolved local questions. If those inputs are missing, a precise-looking cube count or construction drawing can create false confidence rather than a buildable plan.
What a Commercial Foam Pit System Includes

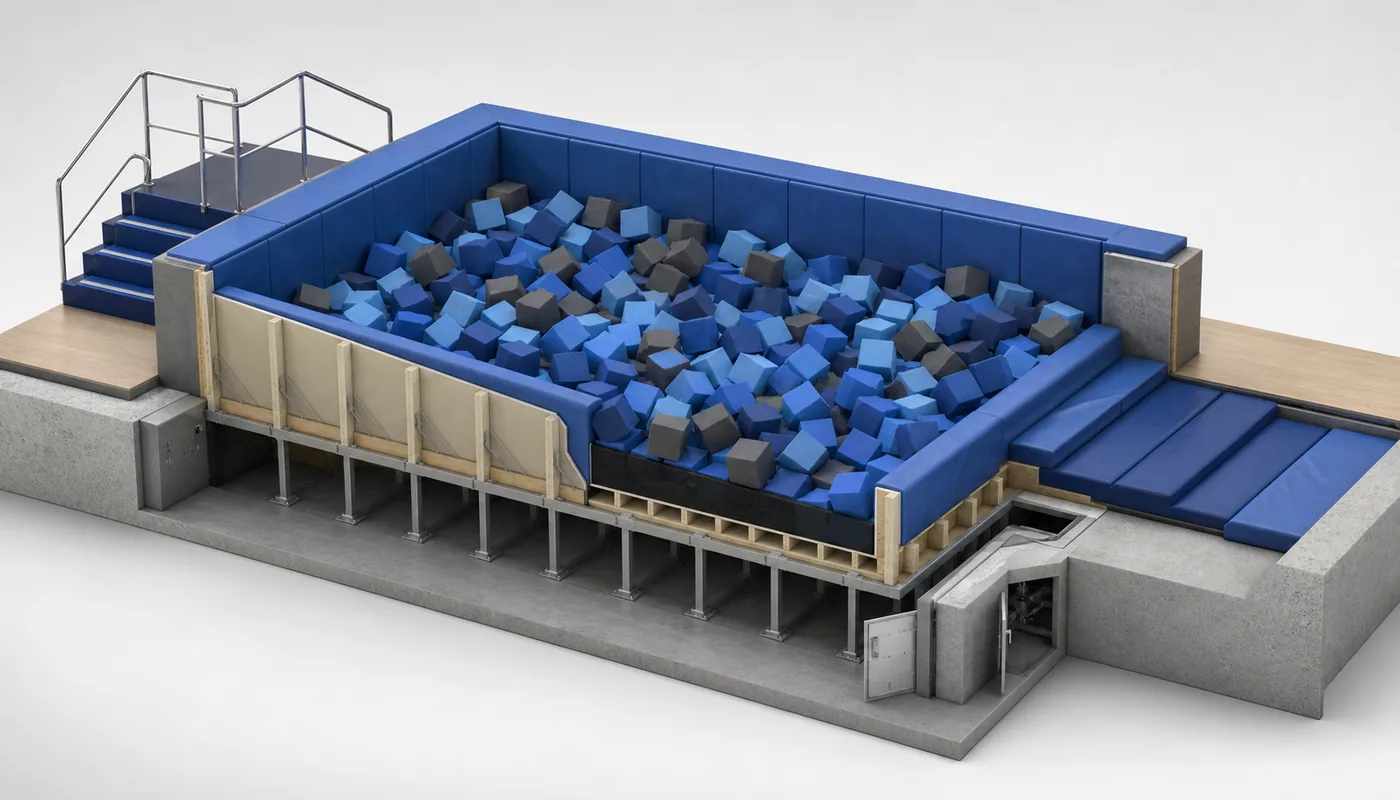

A commercial foam pit is easier to evaluate as five connected layers. Each layer has a different function, owner, inspection need, and failure mode. Changing one layer can affect the others.
1. Site Layer
The site layer includes the building floor, clear height, surrounding platforms, circulation routes, utilities, drainage or moisture conditions where relevant, and access for installation and maintenance. It also includes the space needed for queues, supervision, assisted exit, and temporary closure. These conditions come from the real venue, not a generic foam-pit drawing.
2. Structural and Base Layer
The structural layer contains the pit enclosure, supporting frame or construction, anchors or interfaces, and the engineered system below the loose fill. The bottom is not a universal stack of materials. Depending on the intended product and activity, a supplier may specify a different support or impact-attenuation arrangement. The buyer's job is to obtain and coordinate that project-specific design, not copy a base detail from a home tutorial.
The limits of the bottom system matter because loose cubes alone do not make every entry condition acceptable. In a laboratory study of head-first entries into three foam-pit configurations, at least one neck-injury assessment reference was exceeded in every configuration tested at a 1.5 m fall height. The authors stressed both adequate foam depth and appropriate overall pit design, while also noting that their tests used limited configurations and a 50th-percentile adult male test device. The study supports a narrow but important conclusion: a foam pit must not be presented as making head-first entry safe. See Whyte et al., 2022, Annals of Biomedical Engineering.
3. Protection Layer
The protection layer covers perimeter pads, protected edges, barriers or containment where specified, and the transitions between the pit and adjacent equipment. It should address the actual approach, landing, exit, and waiting areas. A pad is useful only when it stays in its intended position, covers the intended hard surface, and can be inspected and replaced.
4. Fill Layer
The fill layer consists of the loose blocks and their documented properties. Cube dimensions, material specification, fire-performance documentation, quantity, color, packaging, and replacement supply are procurement questions. No single density or block size can be declared best for every project from the keyword alone. Ask the system supplier to identify the required specification and ask the material supplier for the documents needed by the project team and local reviewers.
5. Operations Layer
The operations layer includes entry control, exit routes, staff sightlines, user instructions, capacity rules, inspection access, cleaning, damaged-block isolation, maintenance records, and stop-use decisions. It is part of the system because staff must be able to see, reach, clean, inspect, close, and reopen the attraction in a controlled way.
This five-layer model prevents a common procurement error: comparing quotes only by pit dimensions and cube quantity. A lower quote may exclude the base system, perimeter protection, access provisions, installation, documentation, or operational handover. Buyers planning a larger venue can review how the pit relates to other commercial trampoline park equipment, but the final interfaces still need project-specific coordination.
How to Build a Commercial Foam Pit in Seven Steps

The following sequence is a project-control workflow. It does not replace structural design, product instructions, installation drawings, or local approval.
Step 1: Define the Intended Use and Landing Path
Document what users will do immediately before entering the pit, how they are expected to enter, where they should land, and how they will exit. Record the target users, supervision model, expected throughput, and prohibited uses. If the venue wants several activities to share one pit, ask the supplier to evaluate each entry condition rather than assuming one configuration covers them all.
Checkpoint: The project brief names the activity, users, entry device, landing direction, exit route, and operator assumptions.
Step 2: Confirm Standards and Site Constraints
Identify the equipment standards, local regulations, insurer conditions, building constraints, and approval responsibilities that apply to the location. Confirm the available plan dimensions and height against an accurate survey. Record nearby columns, walls, platforms, doors, evacuation routes, and other interfaces that could affect the layout.
Checkpoint: The project has a jurisdiction list, current site information, and a named party responsible for each unresolved requirement.
Step 3: Coordinate the Structure and Base System
The equipment supplier and relevant project professionals should coordinate the enclosure, supporting structure, bottom system, adjacent equipment, and building interfaces. Request drawings that distinguish supplied equipment from owner-provided or locally constructed work. Do not approve a detail simply because it resembles a pit shown in a different venue.
Checkpoint: Drawings identify the structural and base components, connection points, design responsibility, exclusions, and required site preparation.
Step 4: Design the Perimeter, Entry, Exit, and Service Access
Coordinate protected edges and transitions with the actual entry device. Keep the waiting route separate from the landing and exit paths where the design requires it. Check whether staff can see the entry and landing zones, whether users can leave without crossing the next user's path, and how staff would assist or close the area. Provide access for inspection below the visible fill and around components that require service.
Checkpoint: The layout shows entry, landing, normal exit, assisted access, staff positions, inspection access, and closure boundaries.
Step 5: Select Documented Foam Blocks and Estimate Quantity
Obtain the block dimensions and required material specification from the system design. Ask what product documents accompany the blocks, how replacement material will be matched, and how the supplier accounts for the net fill volume and operating allowance. Calculate an initial quantity only after the effective fill zone is confirmed; the calculation method appears in the next section.
Checkpoint: The purchase specification identifies block dimensions, material documentation, quantity basis, packaging, and replacement source.
Step 6: Install, Inspect, and Document the System
Install to the approved drawings and product instructions. Record deviations instead of resolving them informally. Before opening, check the completed structure, protection, fill, entry, exit, signage, access, and surrounding surfaces against the agreed documents. Collect the drawings, product specifications, installation records, inspection forms, and open issues in one handover file.
Checkpoint: The completed installation has documented acceptance checks, resolved deviations, and an indexed handover package.
Step 7: Train Staff and Complete Operational Handover
The venue must be ready to operate the pit, not merely possess it. Assign responsibility for pre-opening checks, in-session monitoring, cleaning, damaged-block removal, maintenance escalation, temporary closure, incident response, and record retention. Train staff with the supplied instructions and confirm who can authorize reopening after a failed check or repair.
Checkpoint: Named staff can follow the operating and inspection procedures, locate the required records, and explain the stop-use and escalation process.
At the end of these seven steps, the project should have more than an installed enclosure. It should have a defined use, coordinated interfaces, traceable materials, inspection access, operating procedures, and clear ownership of unresolved work. Those are the conditions needed before a cube estimate or supplier quotation becomes meaningful.

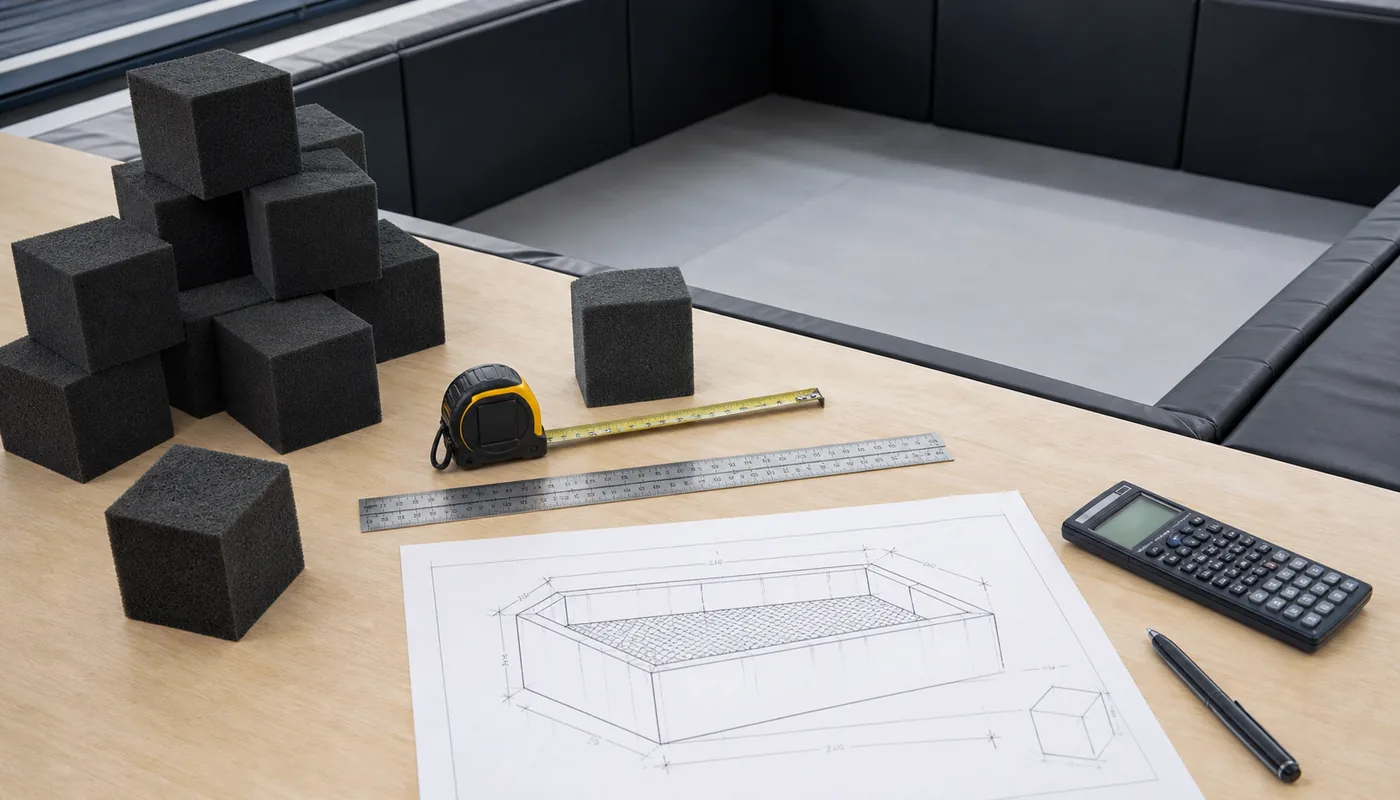

How to Estimate the Number of Foam Cubes

Calculate foam cubes only after the supplier has confirmed the effective fill zone. Start with consistent units and use the clear internal volume occupied by loose fill, not the outside dimensions of the enclosure.
Net fill volume = clear length x clear width x confirmed effective fill depth
Individual cube volume = cube length x cube width x cube height
Initial cube count = net fill volume / individual cube volume
For an arithmetic example, suppose an approved drawing identifies a net fill volume of 14.4 m3 and the specified block volume is 0.008 m3. The simple division gives an initial count of 1,800 blocks. Those figures demonstrate the calculation only; they are not recommended pit dimensions or a purchase quantity.
| Quantity check | What to confirm before ordering |
|---|---|
| Effective volume | Has the base system, sloped area, step, projection, or other obstruction been deducted? |
| Cube dimensions | Are all dimensions expressed in the same unit, and do they match the quoted product? |
| Packing behavior | How does the supplier account for voids between loose blocks? |
| Operating condition | What allowance does the system supplier use for settlement, movement, and maintaining the required operating level? |
| Packaging | How many blocks are supplied per carton, bag, bale, or shipment unit? |
| Replacement stock | Does the venue need matching spare blocks for damaged or removed pieces? |
Do not add an arbitrary percentage copied from another website. Ask the system supplier to show how the final quantity was derived and how the operator will judge the acceptable fill condition after opening.

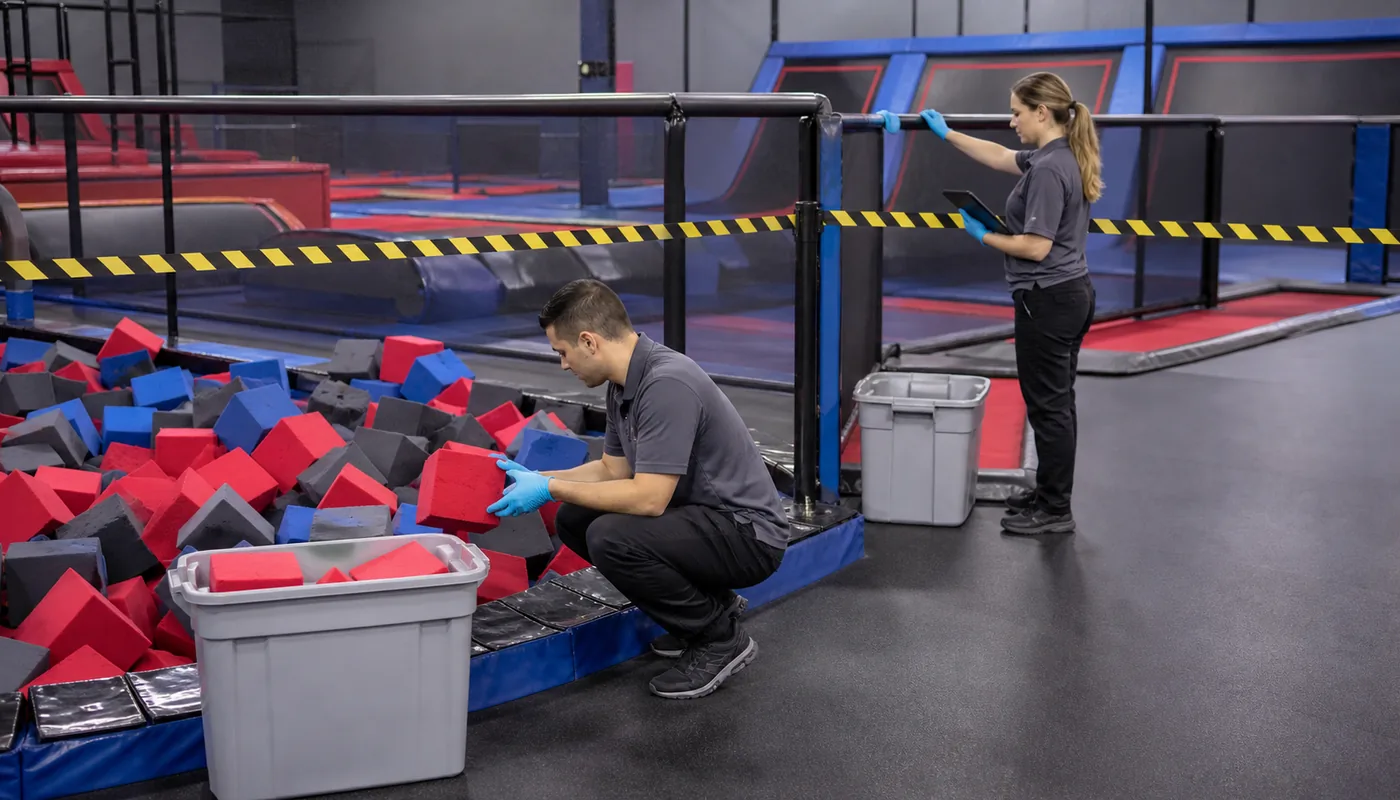

Design for Inspection, Cleaning, and Replacement

The answer to "How dirty is a foam pit?" cannot be reduced to an unsupported germ count. Loose blocks can conceal dust, debris, personal items, damaged material, and components below the visible surface. The practical question is whether the venue can inspect and clean all required areas without improvising a hazardous process.
The Fun Spot Foam Pit Owner/Operator Manual illustrates the scope of a manufacturer-specific program: its inspection material covers padding, containment, structural and trampoline components, debris, damaged cubes, areas under the platform, cleaning, records, and closure after a failed check. Its daily, weekly, and other intervals apply to that manufacturer's system and should not be copied as a universal schedule.
| Operating task | Design or handover question |
|---|---|
| Surface check | Can staff see displaced fill, damaged blocks, debris, exposed protection, and blocked exits? |
| Deep inspection | Can trained staff reach the required lower layers and underlying components under a controlled closure? |
| Cleaning | Where will blocks be removed, cleaned with approved products, dried, and held before return? |
| Replacement | How will staff identify, isolate, match, and replenish damaged blocks? |
| Component inspection | Which pads, mats, frames, anchors, nets, or interfaces require access and specialist service? |
| Stop-use decision | What condition triggers closure, who records it, and who can authorize reopening? |
The cleaning frequency should come from the equipment and material instructions, use intensity, incident history, risk assessment, and applicable local requirements. Plan the labor, temporary storage, access equipment, and downtime before approving the layout. A pit that cannot be emptied or inspected as intended is not operationally complete.

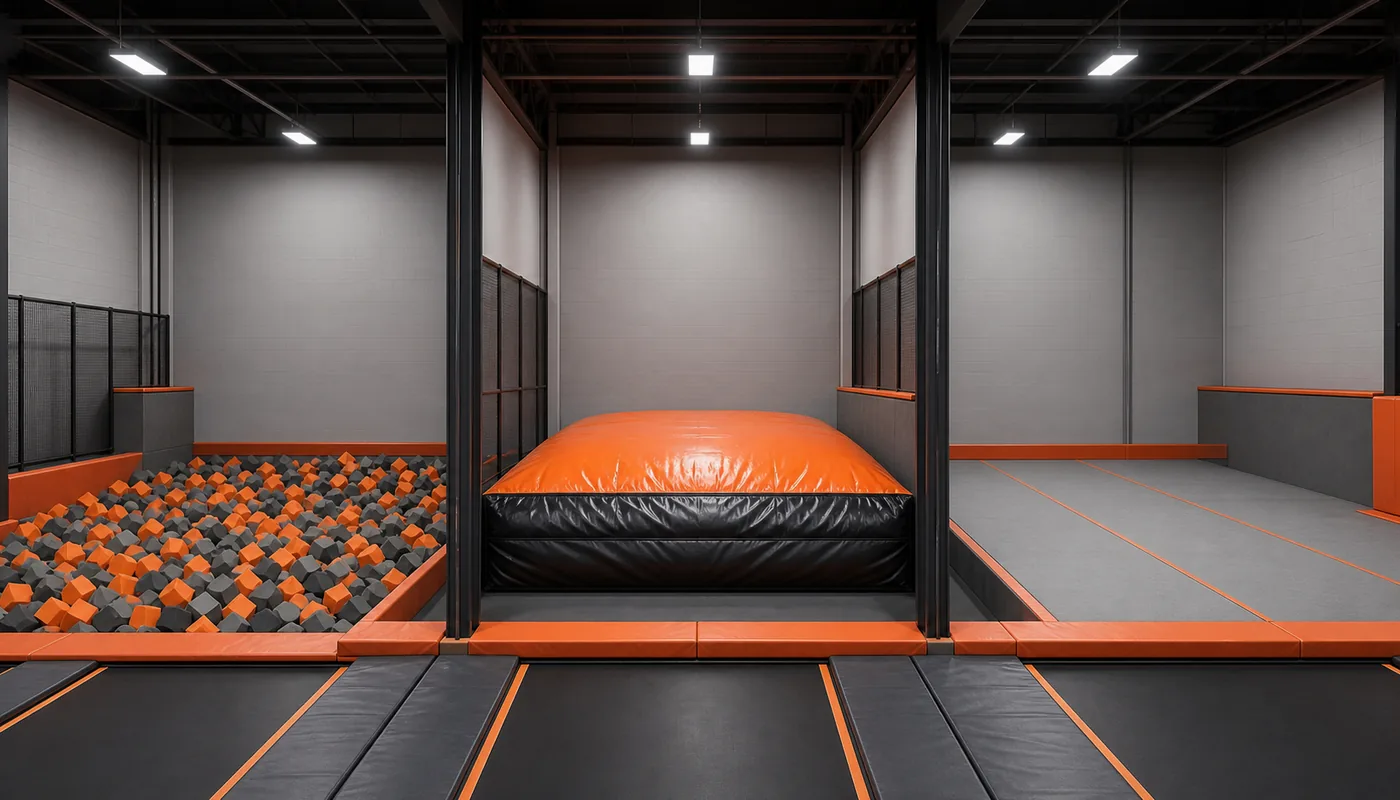

Foam Pit vs Airbag vs Padded Floor

Building a foam pit is not always the only way to support a planned activity. Compare the entire operating system rather than choosing by the apparent softness of the landing surface. ISO 23659:2022 expressly includes landing areas such as airbags and foam pits within its scope, but that does not make the two systems interchangeable.
| Decision factor | Foam pit | Airbag landing | Padded floor or deck |
|---|---|---|---|
| Intended use | Loose-block landing or training area defined by the system design | Inflated landing system for a defined entry and landing pattern | Protected surface for activities designed to finish on that surface |
| Exit | Requires a planned route through or out of loose fill | Requires a clear route off the inflated surface | Usually connects directly to the surrounding floor or platform |
| Inspection | Includes loose blocks, hidden areas, protection, and underlying components | Includes fabric, seams, inflation equipment, pressure or operating condition, and surrounding protection | Includes surface condition, seams, attachment, edges, and underlying construction |
| Cleaning | Requires a process for blocks and concealed areas | Requires product-approved surface and system cleaning | Requires product-approved surface cleaning and access to damaged areas |
| Main buyer question | Can the venue manage fill condition, access, and block replacement? | Can the venue manage inflation, inspection, exit flow, and specialist maintenance? | Does the activity and fall condition suit this designed surface? |
For a deeper comparison, review airbag landing systems and foam pits vs padded floors. The appropriate option depends on the activity, site, users, supplier design, operating resources, and applicable requirements; none is automatically best for every venue.
Common Foam Pit Planning Mistakes

Most avoidable problems begin before installation. Use the following table as a design-review agenda rather than waiting for a site team to resolve missing decisions.
| Mistake | Why it creates risk or rework | Better action |
|---|---|---|
| Choosing depth before defining the activity | A number is detached from entry conditions, users, and the base system | Complete the activity and site brief first |
| Buying cubes before approving the system | The net volume and required specification may change | Freeze the effective fill zone and product specification before ordering |
| Treating loose blocks as the whole pit | Structure, base, protection, access, and operations disappear from the quote | Compare every layer of the complete-system model |
| Copying a home DIY detail | A domestic enclosure does not establish suitability for a public landing attraction | Use project-specific supplier documents and local professional review |
| Ignoring exit and assisted access | The venue discovers flow or retrieval problems after construction | Draw normal exit, staff access, and closure boundaries with the landing path |
| Treating a material claim as project compliance | One foam test or label cannot settle building, fire, or equipment requirements | Map each document to the requirement and authority it is intended to address |
| Hiding maintenance access | Staff cannot reach lower components without an improvised process | Review emptying, inspection, cleaning, drying, and replacement before approval |
| Leaving scope exclusions verbal | Owner and supplier make different assumptions about site work | Put inclusions, exclusions, interfaces, and acceptance records in writing |
The strongest correction is sequencing: purpose before dimensions, system design before cube orders, and operational planning before handover.
Foam Pit Quote and Handover Checklist

A useful quotation should let the buyer see what is supplied, what remains site work, and which assumptions could change the price or schedule. Send every bidder the same project brief, then compare scope rather than the total alone.
| Quote category | Questions for the supplier |
|---|---|
| Design basis | Which activity, users, entry method, site drawing, standard, and operating assumptions support the proposal? |
| Equipment scope | Are the structure, base system, perimeter protection, containment, entry, exit, and accessories included? |
| Foam fill | What block dimensions, material documents, quantity basis, packaging, and replacement source are specified? |
| Site work | Who handles excavation or floor work, anchors, utilities, access, storage, lifting, waste, and local finishes? |
| Logistics | Who is responsible for freight, customs, unloading, protected storage, shortages, and damaged packages? |
| Installation | Who supplies labor, supervision, tools, testing, deviation control, and completion records? |
| Compliance support | Which product documents are supplied, and which local reviews or approvals remain outside the supplier's scope? |
| Operations | Are inspection forms, maintenance instructions, cleaning guidance, training, spare parts, and stop-use criteria included? |
| Acceptance | What documents and checks define completion, defects, correction, and final handover? |
Review the wider trampoline park equipment budget and trampoline park maintenance before comparing the pit as an isolated purchase. FEI FAN's published project service information and certification information can also be reviewed when defining the requested scope and documents; the buyer must still confirm what applies to the specific product and jurisdiction.
Plan the Foam Pit as a Complete System

Building a commercial foam pit is a sequence of connected decisions: define the activity, confirm the site and applicable requirements, coordinate the structure and base, protect the perimeter, specify the fill, plan inspection access, and prepare the operating team. Do not let a familiar cube-count question hide the harder interfaces. A useful supplier discussion starts with accurate project inputs and ends with drawings, documented scope, inspection procedures, training, and clear responsibility for unresolved local work.
